Press ESC or click anywhere outside to close

A successful water source heat pump installation starts before the equipment reaches the mechanical room. The installer must verify the source-water quality, sustainable flow, operating temperatures, hydraulic resistance, building load, terminal-water temperatures and maintenance access.

For a broader comparison of groundwater, engineered water-loop and ground-loop systems, read the Water and Ground Source Heat Pump System Design Guide.

This article has a narrower boundary. It explains how to integrate a water-to-water heat pump with an open water source or protected secondary loop. It focuses on water analysis, flow calculation, filtration, isolation heat exchangers, service clearances and commissioning. It does not replace well design, building-load calculation, local permitting or the complete procurement framework covered by the pillar guide.


What Buyers Should Verify Before Ordering

Project buyers usually focus first on capacity and price. However, installation risk is often controlled by five less visible questions:

  1. Can the water source provide the required flow in every operating season?
  2. Is the water chemically and physically compatible with the heat exchanger?
  3. Will source water pass directly through the heat pump, or will an isolation heat exchanger be used?
  4. Does the equipment room provide sufficient access for cleaning, testing and component replacement?
  5. Are commissioning acceptance criteria written into the contract?

A nominally correct heat pump can still suffer from low-flow alarms, heat-exchanger fouling, unstable outlet temperatures or excessive pump electricity if these questions remain unresolved.

Therefore, the final order should identify both the selected unit and its installation conditions.


Water Source Heat Pump Selection Input Table

The following information should be completed before final model selection.

Selection inputRequired project informationStatus required before purchase
Project locationCountry, city, elevation and applicable weather conditionsBuyer to provide
Building heating loadDesign heating load at stated indoor and outdoor conditionsTo be calculated
Building cooling loadSensible and latent cooling load, including ventilationTo be calculated
Domestic hot waterPeak demand, daily volume, storage temperature and priorityBuyer and designer to confirm
Operating scheduleDaily hours, seasonal operation and simultaneous loadsBuyer to provide
Source typeProduction well, lake, river, mine water, wastewater or engineered loopBuyer to identify
Source temperatureMinimum, normal and maximum entering-water temperaturesTo be measured or supported by site data
Sustainable source flowAvailable flow under long-duration pumping conditionsTo be measured
Static and pumping levelsWater levels at rest and at design flowRequired for well-pump selection
Water chemistryLaboratory analysis covering the parameters in this articleTo be measured
Sand and suspended solidsConcentration and expected seasonal variationTo be measured
Return arrangementDischarge, reinjection or another approved methodDesigner and authority to confirm
Heating-water temperatureRequired supply and return temperaturesProject designer to confirm
Cooling-water temperatureRequired chilled-water supply and return temperaturesProject designer to confirm
Source-side pressure lossPipes, strainers, valves, heat exchanger and fittingsTo be calculated
Load-side pressure lossHeat pump, buffer, terminals, valves and fittingsTo be calculated
Electrical supplyVoltage, phase, frequency and available capacityBuyer to provide
Control requirementsStandalone, cascade, BMS, Modbus or remote monitoringBuyer to specify
Required quantityInstalled, duty and standby quantitiesSupplier and buyer to confirm
Service limitationsDoor size, lifting route, floor loading and maintenance spaceTo be measured

A supplier cannot determine reliable pump duty or project-condition capacity from building area and required outlet-water temperature alone.


Recommended Installation Boundary

A water source heat pump installation may use either direct source-water connection or an isolation heat exchanger.

For projects with uncertain water chemistry, sediment or biological activity, an isolation plate heat exchanger can separate the raw source water from a protected closed loop connected to the heat pump. However, this arrangement introduces additional temperature approach, pressure loss, pumping power and cleaning requirements.

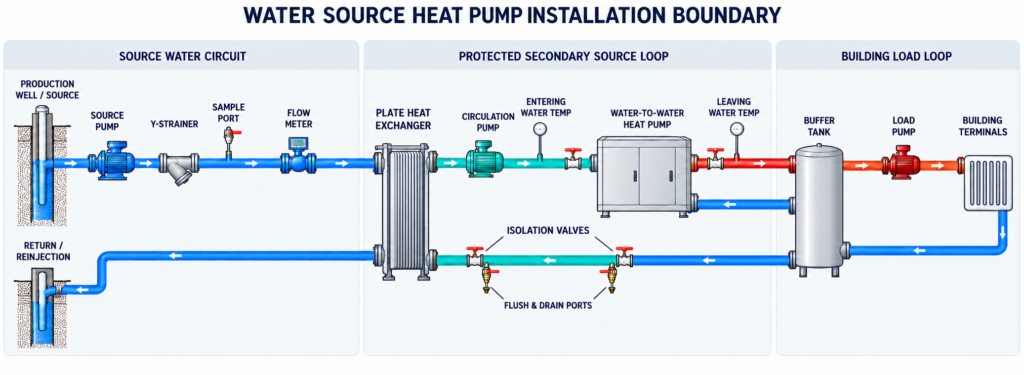

Figure 1. Conceptual water source heat pump installation boundary. The isolation heat exchanger protects the heat pump from direct source-water exposure, while measurement, flushing and service points support commissioning. The final arrangement remains project- and model-specific.

The diagram is not a construction drawing. In particular, valve quantity, bypasses, expansion equipment, air separation, strainers, heat-exchanger materials and safety devices must be completed by the project engineer.

Conceptual water source heat pump installation with source-water filtration, isolation heat exchanger, protected loop and building circuit

Direct Source Water or Isolation Heat Exchanger?

Neither arrangement is universally correct.

Decision factorDirect source-water connectionIsolation heat exchanger
Heat-transfer pathSource water passes through the heat pump’s source heat exchangerRaw water is separated from the heat pump by an intermediate exchanger
Temperature penaltyNo intermediate exchanger approachAdditional temperature approach must be calculated
Pumping circuitsPotentially fewer componentsRaw-water and protected-loop pumps may both be required
Fouling exposureHeat pump exchanger receives the source water directlyReplaceable or cleanable isolation exchanger takes most source-water exposure
Water chemistry requirementMust meet the exact heat pump manufacturer’s limitsRaw-water side must match the isolation exchanger material and treatment plan
Maintenance impactCleaning may require opening or chemically cleaning the heat pump circuitIsolation exchanger may be easier to isolate and clean
Freeze protectionModel and source conditions determine requirementsProtected loop can use an approved antifreeze where necessary
Appropriate conditionStable, analysed water expressly accepted for the exact modelVariable chemistry, sediment, corrosion or maintainability concerns
Inappropriate conditionUnknown water analysis or chemistry outside written limitsUnacceptable approach temperature, pressure loss or lifecycle cost

The correct acceptance rule is straightforward: use direct connection only when the exact model documentation and a representative water analysis establish compatibility. A general statement that the water “looks clean” is not evidence.

Similarly, specifying an isolation exchanger does not remove all water risk. Its plate material, gasket material, fouling allowance, cleaning method and design velocity still require engineering review.


Water Quality Must Be Analysed

Source water can carry dissolved minerals, suspended solids, sand, corrosion products and biological material. These can cause scale, corrosion, erosion, blockage or biofouling.

The 2023 ASHRAE Handbook chapter on water treatment explains that water-treatment strategy depends on water chemistry, operating conditions, system metallurgy and manufacturer requirements. It also identifies scale, corrosion, deposition and biological growth as distinct problems requiring different controls.

Therefore, a water report should cover more than pH and hardness.

Water parameterInstallation riskRequired decision
TemperatureDefines operating point and potential heat-pump capacityCompare seasonal range with exact model envelope
pHInfluences corrosion and material compatibilitySupplier and heat-exchanger manufacturer to confirm limit
Total hardnessIndicates scale potentialWater-treatment specialist to assess
AlkalinityAffects scaling indices and treatment selectionInclude in chemistry review
Conductivity or TDSIndicates dissolved ionic contentCompare with material and treatment limits
ChlorideCan accelerate corrosion of susceptible materialsConfirm allowable value for exchanger material
SulfateMay contribute to corrosion or deposit riskSpecialist to assess
Iron and manganeseCan oxidise, precipitate and foul surfacesAssess filtration and cleaning requirements
SilicaMay form difficult deposits under some conditionsTreatment specialist to assess
TurbidityIndicates suspended materialEstablish filtration requirement
Total suspended solidsCan block strainers and foul exchangersEstablish separator or filter duty
Sand contentCan cause erosion and rapid blockageVerify well development and sand separation
Dissolved oxygenInfluences corrosion in open systemsInclude in materials review
Microbiological activityCan produce biofilm and microbiologically influenced corrosionEstablish monitoring and treatment plan
Oil or process contaminationMay attack seals or foul surfacesReject or treat according to specialist assessment

The acceptance limits in this table are deliberately not generic numbers. They must come from the offered model, selected exchanger materials, water-treatment specialist and applicable local requirements.

A water sample taken once during drilling may also be insufficient. Where seasonal variation is credible, the engineer should determine whether samples are needed at different water levels, flows or times of year.


Strainers Are Not a Complete Water-Treatment System

A Y-strainer can intercept relatively large debris. However, it does not automatically remove fine silt, dissolved minerals, microorganisms or scale-forming chemistry.

Depending on the source, the installation may require:

Filter mesh should not be selected independently of the permitted pressure drop and heat-exchanger passage size. A finer filter may improve solids removal, but it can also block more rapidly and reduce system flow.

Consequently, the design should state the clean and dirty filter pressure drops, alarm threshold, cleaning access and spare-element requirement.


Open-Loop Water Requires Legal Review

A technically available water source is not necessarily legally usable.

For example, the U.S. Environmental Protection Agency identifies heat-pump return-flow wells as a category of Class V underground injection well. Its Class V well fact-sheet page provides a specific downloadable sheet for heat pump and air-conditioning return-flow wells.

Other jurisdictions may regulate:

These requirements vary by location. Therefore, neither CASSKY nor the equipment installer should be assumed to hold responsibility for permits unless that responsibility is explicitly stated in the contract.

A system should not be released for production based on an assumed future permit.


Calculate Flow from the Correct Heat Quantity

Source-side flow should be calculated from the heat transferred on the source side, not automatically from the building load.

For water:

Heat transfer = Mass flow × Specific heat capacity × Temperature difference

Therefore:

Mass flow = Heat transfer ÷ (Specific heat capacity × Temperature difference)

For pure water near normal HVAC temperatures, a preliminary specific heat value of approximately 4.186 kJ/kg·K can be used. Final calculations should use the properties at the design temperature and concentration.

Hypothetical Heating Example

This example is for calculation explanation only. It is not CASSKY model data or a project case.

Assume:

The heat pump electrical input is:

120 kW ÷ 4.0 = 30 kW

Therefore, the heat extracted from the water source is:

120 kW − 30 kW = 90 kW

The required water mass flow is approximately:

90 ÷ (4.186 × 4) = 5.38 kg/s

At an approximate water density of 1 kg/L, this is about 5.4 L/s, or 19.4 m³/h.

This result is a preliminary thermal flow. It does not include a safety margin, plate heat-exchanger approach, fouling, fluid-property correction or the selected unit’s minimum and maximum flow limits.

If glycol is used in a protected secondary loop, use the actual mixture’s density, specific heat and viscosity. Do not reuse the pure-water result.


Pump Power Can Change the System Result

Available flow alone is insufficient. The pump must overcome the total dynamic resistance at that flow.

The pressure-loss calculation should include:

Using the previous hypothetical flow of 5.4 L/s, assume a closed-loop pressure requirement of 120 kPa and combined pump and motor efficiency of 65%.

The approximate electrical input is:

0.0054 m³/s × 120,000 Pa ÷ 0.65 = approximately 1.0 kW

This is only an illustrative pump calculation. The actual duty must come from the hydraulic model and selected pump curve.

For a groundwater pump, static lift, pumping water level and reinjection conditions can produce a much higher duty. Therefore, a project with an attractive heat-pump COP may still have disappointing system efficiency if source pumping energy is excessive.


Verify Sustainable Well Flow

A short pump test showing that water reaches the surface does not establish long-term system flow.

For a groundwater installation, request:

The U.S. Department of Energy’s geothermal purchasing guidance identifies water temperature, well flow and water quality as important groundwater-system properties.

The acceptance flow should be available at the required pumping level without unacceptable sand production or well interference. Additionally, the return arrangement must accept the same operating flow where reinjection is used.


Match Equipment Data to Project Conditions

The CASSKY All-in-One Water / Ground Source Heat Pump is publicly described as a reversible water-to-water platform for water or ground loops.

Published series informationPublic valueEvidence boundary
Heating capacity6–30 kWPreliminary series range; exact model and condition to be confirmed
Cooling capacity5–26 kWPreliminary series range; exact model and condition to be confirmed
Heating outlet waterUp to 60°CMaximum outlet condition, not proof of capacity or COP at 60°C
Cooling outlet waterDown to 7°CSource conditions and capacity remain model-specific
Reference heating COPUp to 4.8 at B0/W35Series reference; not every model or water-source condition
Reference cooling EERUp to 5.2 at W30/W7Series reference; units and test boundary to be confirmed
Electrical supply220–240 V single-phase or 380–415 V three-phaseModel-specific
CommunicationRS485/Modbus RTUModel-specific
Public application scopeVillas, apartments and light commercial buildingsLarge commercial or modular arrangements require separate review

For a water-source project, request performance at the actual minimum and maximum source temperatures. In addition, request capacity and input at the required heating, cooling and domestic-hot-water outlet temperatures.

A B0/W35 reference result cannot be substituted for a project operating at W10/W55. The source fluid, temperature lift and operating condition are different.


Laboratory Performance Is Not Installation Acceptance

ISO 13256-2:2021 covers testing and rating of factory-made water-to-water and brine-to-water heat pumps at defined source- and load-side conditions.

A report under this standard may substantiate:

However, it does not prove:

Similarly, electrical safety evaluation and market compliance are separate from performance testing. The current IEC base reference is IEC 60335-2-40:2024 with Amendment 1:2026, but the required national adoption and product scope depend on the target market.

Therefore, buyers should request the exact model’s reports and certificates rather than accepting a document for a related product family.


Minimum Hydraulic Components to Review

The exact arrangement depends on the project, but the design review should address:

A flow switch is a protective device. It does not prove that the design flow has been achieved. Commissioning should still measure actual flow or derive it using an accepted calibrated method.


Does Every Installation Need a Buffer Tank?

No. A buffer tank should be based on system volume, minimum unit output, minimum compressor runtime, zoning and hydraulic configuration.

It is more likely to be required when:

However, an oversized or poorly connected tank can add heat loss, cost and control complexity. Therefore, tank volume and connection method should be calculated rather than copied from another project.


Service Access Must Be Designed, Not Assumed

Equipment-room access affects installation, commissioning and future repair. A cabinet that fits between two walls may still be unserviceable.

Before approving the layout, confirm access for:

There is no universal clearance that can safely be applied to every model. Request a dimensioned installation drawing for the offered unit and identify the service side, connection side and component-removal paths.

The public CASSKY product page shows cabinet and internal-layout views, but those images do not define contractual clearances. Exact model drawings should be requested before fixing walls, pipes, cable trays or adjacent equipment.


Common Layout Errors

Pipes Block the Service Panel

A pipe may connect correctly while preventing electrical or compressor access. Route headers outside the documented service zone.

The Strainer Cannot Be Removed

Allow space to withdraw the strainer screen without cutting pipework. Also provide isolation and a safe drainage route.

The Plate Heat Exchanger Has No Cleaning Connections

If fouling is foreseeable, provide valves and ports for cleaning, flushing and differential-pressure measurement.

The Flow Meter Is Installed in Disturbed Flow

Respect the meter manufacturer’s straight-run, orientation, grounding and fluid requirements. Otherwise, the displayed value may not be reliable.

Sensors Are Installed Far from the Equipment

Temperature sensors used for acceptance should represent the fluid entering and leaving the heat pump or heat exchanger. Long uninsulated pipe runs can distort the result.

Drainage Is Ignored

Strainer cleaning, sampling, flushing and component removal release water. The plant room needs a controlled drainage plan rather than reliance on temporary buckets.


Installation Design Boundaries

Responsibility should be assigned explicitly.

Design packageTypical responsible partyMinimum deliverable
Building loadsHVAC consultant or project engineerHeating, cooling and DHW load report
Source feasibilityHydrogeologist or qualified water-source designerFlow, temperature, chemistry and permit assessment
Wells and reinjectionLicensed local specialistWell design, pump test and acceptance records
Heat pump selectionSupplier with project engineer reviewModel and multi-condition performance
Water treatmentQualified water-treatment specialistLimits, treatment, monitoring and maintenance plan
Isolation heat exchangerSystem designerMaterial, duty, approach temperature and pressure loss
HydraulicsProject mechanical engineerFlow, pipe sizing, pump head and control valves
Electrical worksElectrical engineer or contractorSupply, protection, isolation and cable schedule
ControlsControls contractor and equipment supplierSequence, points list and communication boundary
CommissioningNamed commissioning partyTest procedure, calibrated records and report

If the supplier provides only the heat pump, it should not be assumed to guarantee well flow, source chemistry, pump energy or complete building performance.

Conversely, an installer should not change the approved source fluid, design flow or control sequence without confirming the effect on the heat pump.


Pre-Start Commissioning Checklist

Do not energise the compressor merely because the pipework is full.

Pre-start checkAcceptance condition
Exact modelNameplate matches approved schedule and electrical supply
Shipping and installation conditionNo visible transport or installation damage
Service clearanceMeets the model-specific approved layout
Pipe connectionsSource and load circuits connected to the correct ports
Water analysisCurrent report reviewed against written equipment and exchanger limits
Strainers and filtersCorrect direction, clean condition and accessible removal
System flushingConstruction debris removed and records available
Pressure testCompleted at the specified test pressure and duration
Water treatmentCorrect treatment and concentration documented
AntifreezeType, concentration and freeze protection measured
Air removalClosed loops fully purged
Expansion equipmentPre-charge and connection verified
Source flowMeasured and within the exact model’s permitted range
Load flowMeasured and within the exact model’s permitted range
PumpsRotation, duty point and electrical input checked
SensorsLocation and plausible reading confirmed
Electrical protectionBreaker, cable, earth and isolation verified
Phase sequenceConfirmed for three-phase equipment
Controller settingsMatch the approved design sequence
ValvesCorrect operating positions marked
DrainageSafe drainage route available
PermitsRequired abstraction, discharge or reinjection approvals available

Any failed item should be corrected or formally accepted through the project’s deviation process before operation.


Functional and Performance Commissioning

After start-up, record stable operation in each required mode.

Source-Side Measurements

Load-Side Measurements

Equipment Measurements

Protection Tests

ASHRAE/IES Standard 202-2024 provides a framework for defining commissioning responsibilities, procedures, documentation and acceptance against the Owner’s Project Requirements.

A start-up sheet containing only refrigerant pressures and an “operating normally” statement is not sufficient evidence of project performance.


Define the Site COP Boundary

Field COP can be calculated in several ways. Therefore, the contract must state which electrical inputs are included.

Possible boundaries include:

  1. Heat pump compressor and internal controls only
  2. Complete heat pump unit
  3. Heat pump plus source-loop pump
  4. Heat pump plus source- and load-side pumps
  5. Complete system including well pump, terminal fans and auxiliary heaters

These results are not interchangeable.

Additionally, the measurement plan should state:

Without this boundary, a site COP value may appear precise while remaining contractually ambiguous.


Handover Documents

The project handover package should include:

Requesting these documents does not mean every document is publicly downloadable. Model-specific files should be confirmed with CASSKY for the exact offered model and target market.


When This Installation Approach Is Appropriate

A protected water-source installation is more appropriate when:

An isolation heat exchanger is particularly relevant where maintainability or source-water exposure presents a material risk.


When It May Be Inappropriate

A water-source heat pump may be a poor choice when:

For example, a deep well with stable temperature may initially appear attractive. However, if the production and reinjection pumps require substantial power, a closed ground loop or another heat source may provide a better whole-system result.


Frequently Asked Questions

Can groundwater flow directly through the heat pump?

Only when the exact model permits direct connection and a representative water analysis meets its written limits. Otherwise, an isolation heat exchanger may reduce equipment exposure.

How much source-water flow is required?

It depends on source-side heat transfer, permitted temperature difference, fluid properties and the selected model’s flow range. Do not calculate it from nominal building capacity alone.

Is a flow switch sufficient for commissioning?

No. A flow switch normally confirms only that flow is above or below its switching threshold. Measure actual flow for commissioning.

Does an isolation heat exchanger eliminate water-treatment requirements?

No. Raw-water fouling, corrosion and biological activity still affect the isolation exchanger. The protected loop also requires appropriate cleaning, filling and corrosion control.

Can a larger pump solve low-flow problems?

Not automatically. A larger pump can increase electricity use, noise, erosion risk and control instability. First verify the hydraulic calculation, restrictions, well yield and permitted equipment flow.

How much clearance does a water source heat pump need?

Clearance is model-specific. Request the installation drawing and check panel opening, filter removal, pump access, component lifting and whole-unit replacement routes.

Can published COP predict annual site performance?

No. Published COP applies to a defined laboratory condition and equipment boundary. Annual site performance also depends on water temperatures, loads, pumps, terminals, controls and operating hours.


Submit Project Data for Preliminary Selection

For preliminary CASSKY selection and integration review, provide:

CASSKY can use these inputs to review a candidate model and identify the model-specific documents that must be requested. Final well, water-treatment, hydraulic, electrical, control and regulatory design should be completed by qualified project professionals.

Leave a Reply

Your email address will not be published. Required fields are marked *
